Corrosion in Infrastructure: The Glasgow M8 Woodside Viaduct Repairs
Dr Shagufta Khan, Editor, CMJ and Stephen Tate, ICorr Immediate Past President
Introduction
Corrosion-related deterioration of major transport infrastructure continues to pose significant safety, operational and financial challenges across the United Kingdom. Few projects illustrate this more vividly than the ongoing refurbishment of the M8 Woodside Viaducts in central Glasgow — a complex engineering task that has attracted national attention due to its scale, cost, technical difficulty and prolonged impact on one of Scotland’s busiest motorway corridors.
Constructed between 1969 and 1971, the twin elevated viaducts at Woodside carry approximately 150,000 vehicles daily through the densest urban section of the M8 motorway. They form a critical link between junctions 16 and 17 near Charing Cross, bridging tightly constrained city streets, long-established residential areas, and Glasgow’s historic subway tunnels.
When extensive corrosion damage was discovered in 2021, particularly to the reinforced concrete crossheads supporting the decks, an immediate programme of lane restrictions and emergency propping was introduced to ensure continued safe operation. The scale of deterioration, combined with constant environmental exposure, ageing materials, and multiple layers
of historic modification, has since led to a multi-year project of unprecedented complexity. Costs have risen from an estimated £81 million to between £126 million and £152 million, while the completion date has shifted from 2023 to the second half
of 2027.
This article summarises the historic context of the viaducts, the corrosion and structural challenges identified, the bespoke engineering solutions implemented, and the wider lessons for long-term asset integrity management of the UK’s post-war transport infrastructure.

Photo: The Twin Elevated Woodside Viaducts Between Junctions 16 and 17 of The M8 Through Glasgow – a Critical Transport Artery Now Undergoing Major Corrosion Related Repairs, Image Courtesy of Transport Scotland.
Background: Completing the North Flank of Glasgow’s Inner Ring Road
The Woodside Viaducts form part of the ambitious Glasgow Inner Ring Road, a post-war urban motorway system planned in the 1940s and formalised in the 1962 Interim Report on the Glasgow Inner Ring Road. Delivered by Scott Wilson Kirkpatrick and Partners, the north flank — including Townhead Interchange and the Woodside Section — was among the most technically ambitious civil engineering works undertaken in Glasgow in the late 1960s.
Construction of Woodside motorway section progressed in two stages:
Stage 1 (1967–1968)
Connected Townhead Interchange to Craighall Road.
• Included distributor roads, pedestrian routes, and major alterations to surface streets.
• Integrated American-style elements such as Botts’ Dots (tactile lane markers), reflecting the influence of US freeway design.
• Prepared foundations and approach routes for the elevated viaducts to be built in Stage 2.
Stage 2 (1969–1971)
Created the twin multi-span Woodside Viaducts, 365 m and 460 m long.
• Utilised precast, post-tensioned concrete beams, up to 80 tonnes each, to maintain traffic flows on surface streets during erection.
• Included seven road bridges, two footbridges, two underpasses and eleven retaining walls.
• Introduced advanced pre-casting techniques and a dedicated casting yard, achieving up to 12 beams per week.
The viaducts were engineered for a 50-mph design speed and projected traffic flows of 100,000 vehicles per day — a volume vastly exceeded today.
Widening Works of the 1990s
By the early 1990s, traffic congestion on the north flank had reached unsustainable levels. Strathclyde Regional Council initiated a widening scheme that added an additional running lane in each direction between Townhead and St George’s Cross.
At Woodside:
The westbound viaduct was significantly widened.
• Abutments were reconstructed and hard shoulders removed in sections.
• New supports and pier modifications were introduced.
• Ramp metering was introduced at J16 in a UK first.
• The design accommodated space originally reserved for future M8 connections.
These works altered load paths, increased carriageway capacity, and added new structural elements – all of which significantly complicate today’s repair strategy, especially where old and new materials interact under environmental exposure.
Structural Investigations: Deterioration Revealed (2020–2021)
Routine inspections in late 2020 and early 2021 revealed worrying signs of structural degradation, prompting more detailed testing.
Key findings included:
1. Severe deterioration of concrete crossheads
These reinforced concrete elements sit atop the piers and support the precast beams.
• Chloride-induced corrosion of steel reinforcement was extensive. • Concrete cracking, spalling and section loss were discovered.
• Freeze–thaw cycling exacerbated deterioration, particularly on exposed edges.
• Saturation due to long-term water ingress had accelerated the damage.

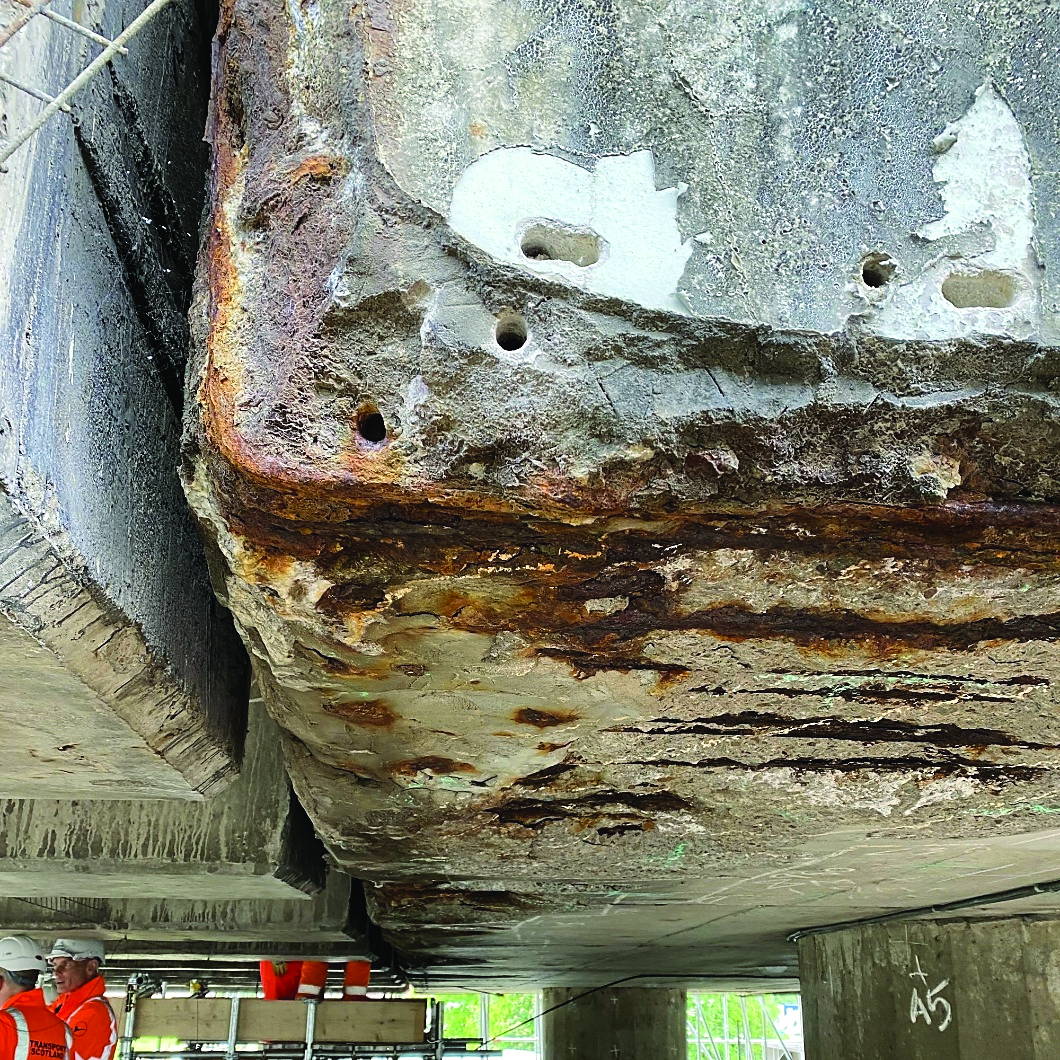

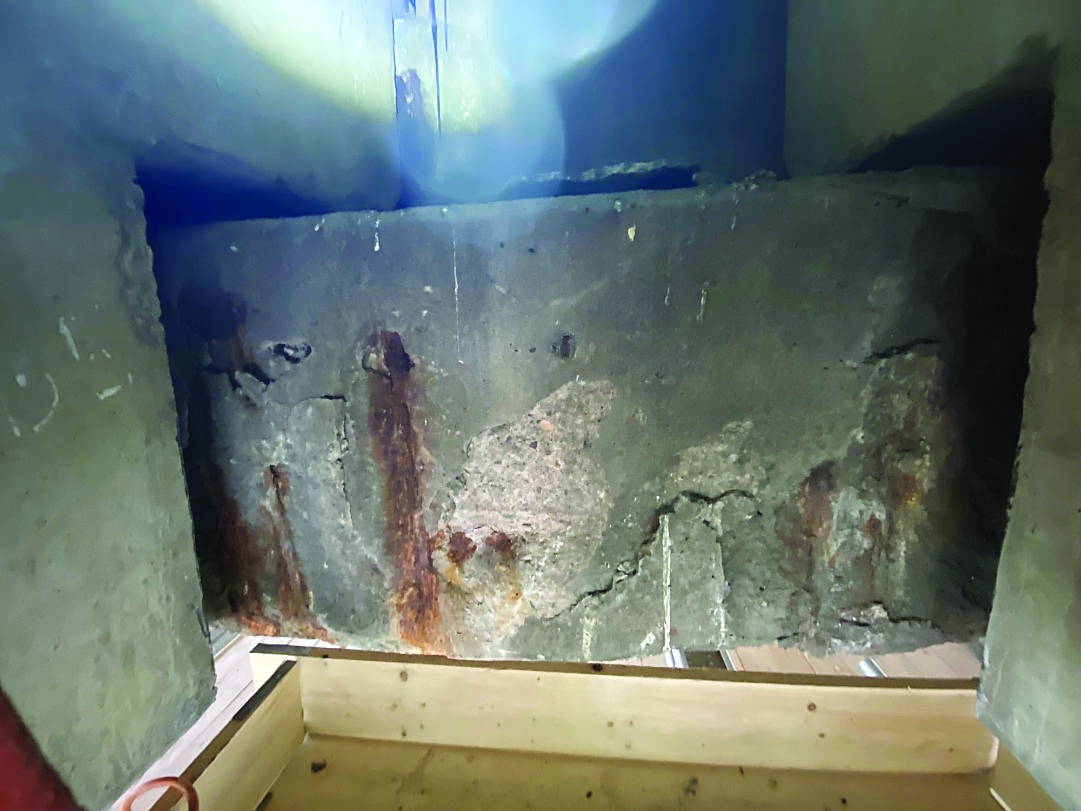

Photo: Crosshead Deterioration Between Beams M8 Woodside Viaduct, Image Courtesy of New Civil Engineer and Transport Scotland.
Photo: Crosshead Deterioration Between Beams M8 Woodside Viaduct, Image Courtesy of New Civil Engineer and Transport Scotland.
2. Water ingress and salt contamination
Decades of exposure due to:
• De-icing salts used in winter had created a highly aggressive environment for both steel and concrete.
• Leaking drainage channels.
• Rainwater run-off from the deck.
3. Load-carrying capacity concerns
Finite element modelling and physical testing indicated that the worst-affected crossheads were no longer provided margins of safety required for 150,000+ daily vehicles.
4. Immediate safety actions
In March 2021:
• Plans for temporary propping were accelerated.
• Restrictive traffic management was introduced.
• Several slip roads were closed.
• The M8 was reduced from four lanes to two in each direction.
The deterioration was more severe than historic records predicted, partly due to a lack of accurate information about hidden structurally relevant elements and services together with the ageing nature of the structures.
Corrosion Mechanisms: Understanding the Root Causes
The degradation at Woodside is a case study in long-term corrosion processes affecting post-tensioned concrete infrastructure.
Chloride Ingress
• Road salts had penetrated the concrete cover over five decades.
• Chlorides de-passivated the steel reinforcement.
• Localised pitting corrosion had occurred, affecting flexural capacity (ability to resist bending stresses).

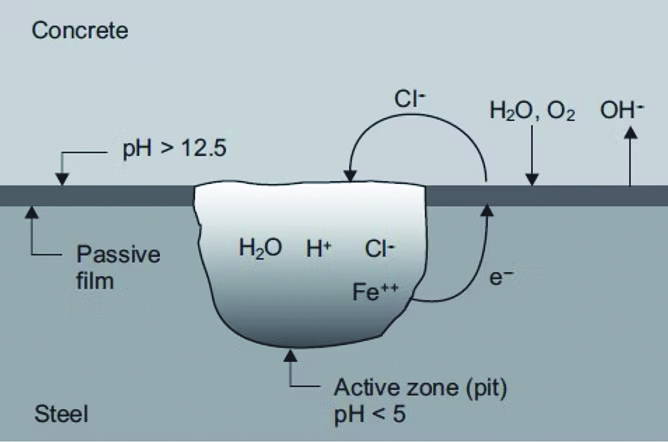

Figure: Chloride Induced Pitting Reinforced Concrete, Image Courtesy of CTL Qatar.
Water Ingress
Persistent leaks (through poor maintenance) and saturated concrete created an ideal environment for corrosion.
Carbonation
Although not the primary deterioration mechanism, carbonation also lowered local pH and weakened concrete at exposed edges.
Hidden Defects from 1960s Construction
Common to many 1960s infrastructure assets that are now reaching the end of their design life.
Historic concrete mixes, workmanship variations, and the use of early post-tensioning systems all contributed to long-term vulnerability and risk of failure in service.
The Repair Strategy: Temporary Steel Propping Systems
To ensure public safety while permanent repairs were developed, engineers adopted an extensive temporary works strategy involving bespoke steel propping at 23x locations.
Design Challenges
Each propping location required a unique solution because of:
• Confined urban spaces.
• Differing pier heights and geometries.
• Interaction with sensitive public utilities.
• Poor or incomplete historic documentation.
• Proximity to Glasgow’s subway tunnels.
• The discovery of an uncharted sewer, which forced redesign and replanning.
• Variable ground conditions
Construction Approach
Each propping location required a unique solution because of:
1. Excavation and piling began in August 2021.
2. High-level steel structures were built to surround and bypass the weakened crossheads.
3. Props were installed progressively from February 2022 onwards.
4. Heavy-duty steel frames transferred live loads away from damaged concrete to the new supports.
5. Propping allowed engineers to undertake investigation, strengthening and reconstruction works without removing the viaduct from service.
Complexity and Safety
This remains one of the most intricate civil temporary-works projects ever undertaken in Scotland. The bespoke nature of the props, complicated interfaces with buried utilities, and need to maintain motorway operation above and city street access below have significantly extended the construction timeline.
Traffic Management and Urban Constraints
The Woodside Viaducts sit in one of the most constrained transport corridors in Scotland. Key challenges included:
• Accommodating diversions through narrow Victorian streets.
• Avoiding disruption to the transport tunnels, which run beneath the structure.
• Ensuring safe pedestrian routes near schools and residential areas.
• Maintaining movement for 150,000+ vehicles per day.
Preserving access beneath the viaduct for residents, businesses and emergency services.
• Working alongside major utility networks (water, gas, power, telecoms).
A new slip road at Junction 17 was constructed to improve westbound traffic flows. Diversions via St George’s Road, Garscube Road and West Graham Street have been essential to maintain operational capacity.
Cost Escalation and Programme Delays
The project’s rising costs and extended schedule reflect its unique challenges:
• Original estimate: £81 million.
• Revised estimate (2024): £126–£152 million.
• Initial completion date: late 2023.
• Current projected completion:
o Eastbound reopening: Autumn 2026.
o Full completion (Westbound): Second half of 2027
Reasons for escalation include:
• Complexity of designing 23x bespoke propping systems.
• Discovery of an uncharted deep sewer.
• Extended traffic management requirements.
• Global supply chain and material price volatility.
• Interference with buried utilities.
• Need for additional strengthening once deterioration. was fully mapped.
• Unexpected ground conditions.
Progress to Date (as of August 2025)
• 13 of 23x propping locations had been completed. • Significant strengthening works were underway.
• Permanent repair solutions were being finalised.
• Eastbound viaduct projected for reopening in 2026 and Westbound to follow in 2027.
• Structural health monitoring and inspection access. improvements have been planned.

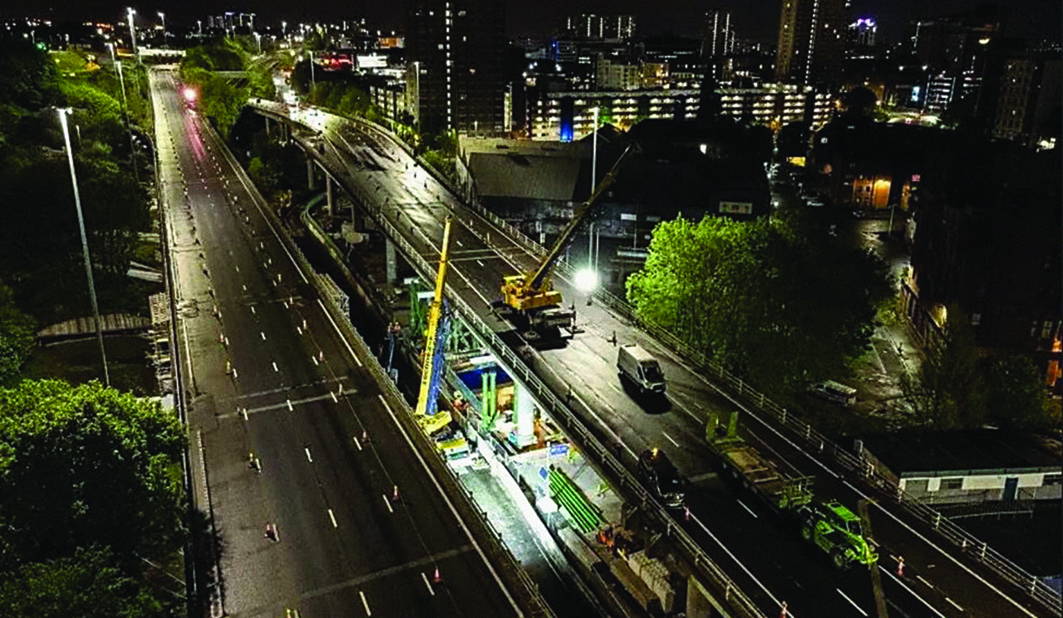

Photo: One of 23x Temporary Props Required for Repairs to M8 Woodside Viaduct, Image Courtesy of ALAMY.
Lessons for UK Infrastructure and Asset Integrity
The Woodside Viaduct project offers wider lessons for the UK’s post-war transport infrastructure.
1. Improved Structural Health Monitoring (SHM)
Permanent SHM systems should be installed on major elevated structures to detect early signs of deterioration.
2. Accurate Records are Essential
Historic discrepancies in utility and structural records have caused major delays and redesigns.
3. Concrete Crossheads are Vulnerable
Many 1960s–70s viaducts use similar reinforced concrete supports and are now approaching end-of-life.
4. Climate and Urban Pollution Accelerate Corrosion Increasing rainfall*, higher ambient temperature, more frequent heatwaves, de-icing salt use and air pollution can all intensify reinforcement corrosion.
* The average rainfall in Scotland between 2010-19 was 9% wetter than the 1961-90 average.

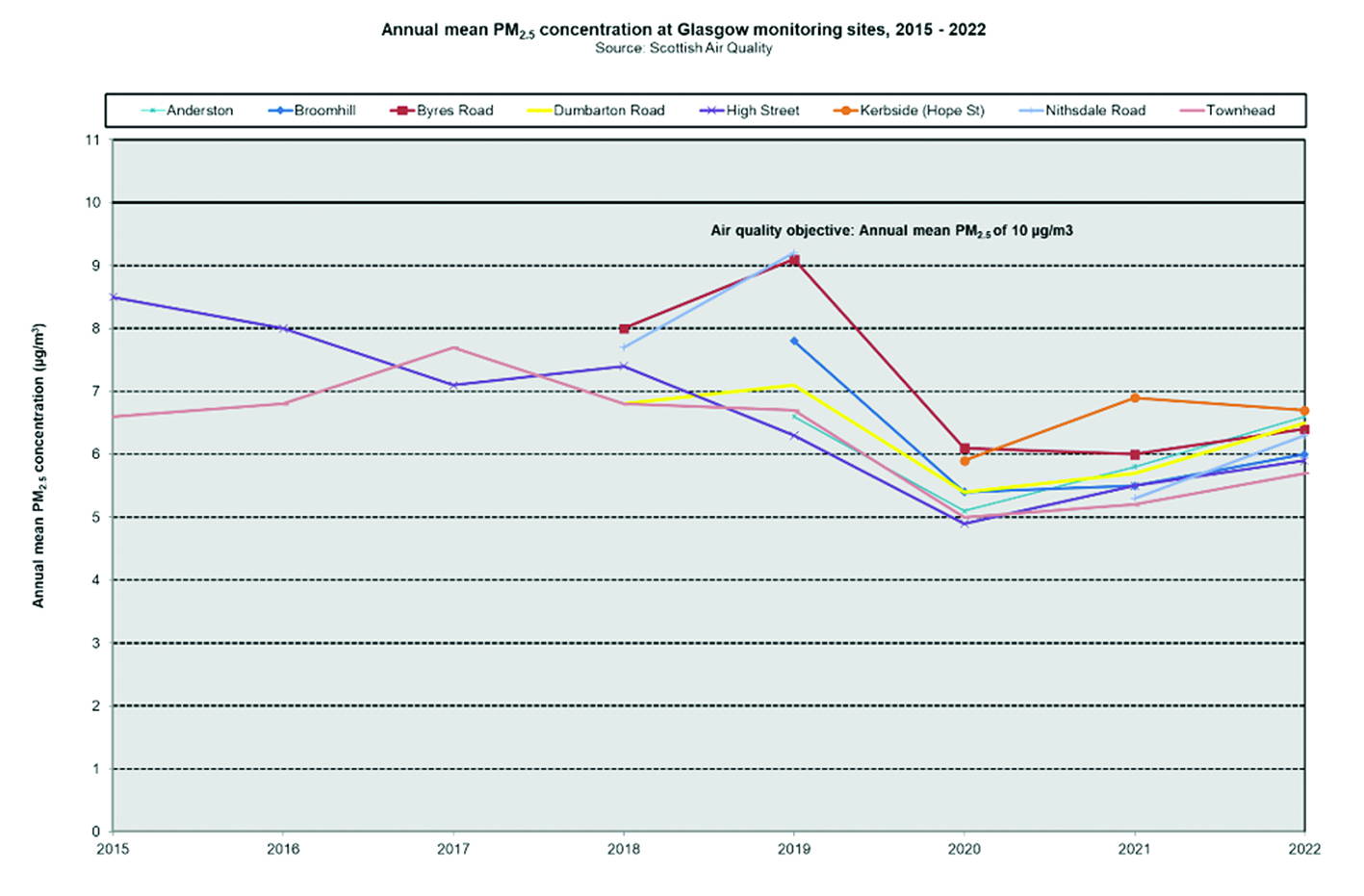

Figure: Annual Mean PM2.5 Concentration at Glasgow Monitoring Sites 2015-2022 (Source: Scottish Air Quality).
Forecasts for peak’ summer temperatures range from 28°C (1980-2010) to 32°C (2050s) and by the 2070s will reach 34°C.

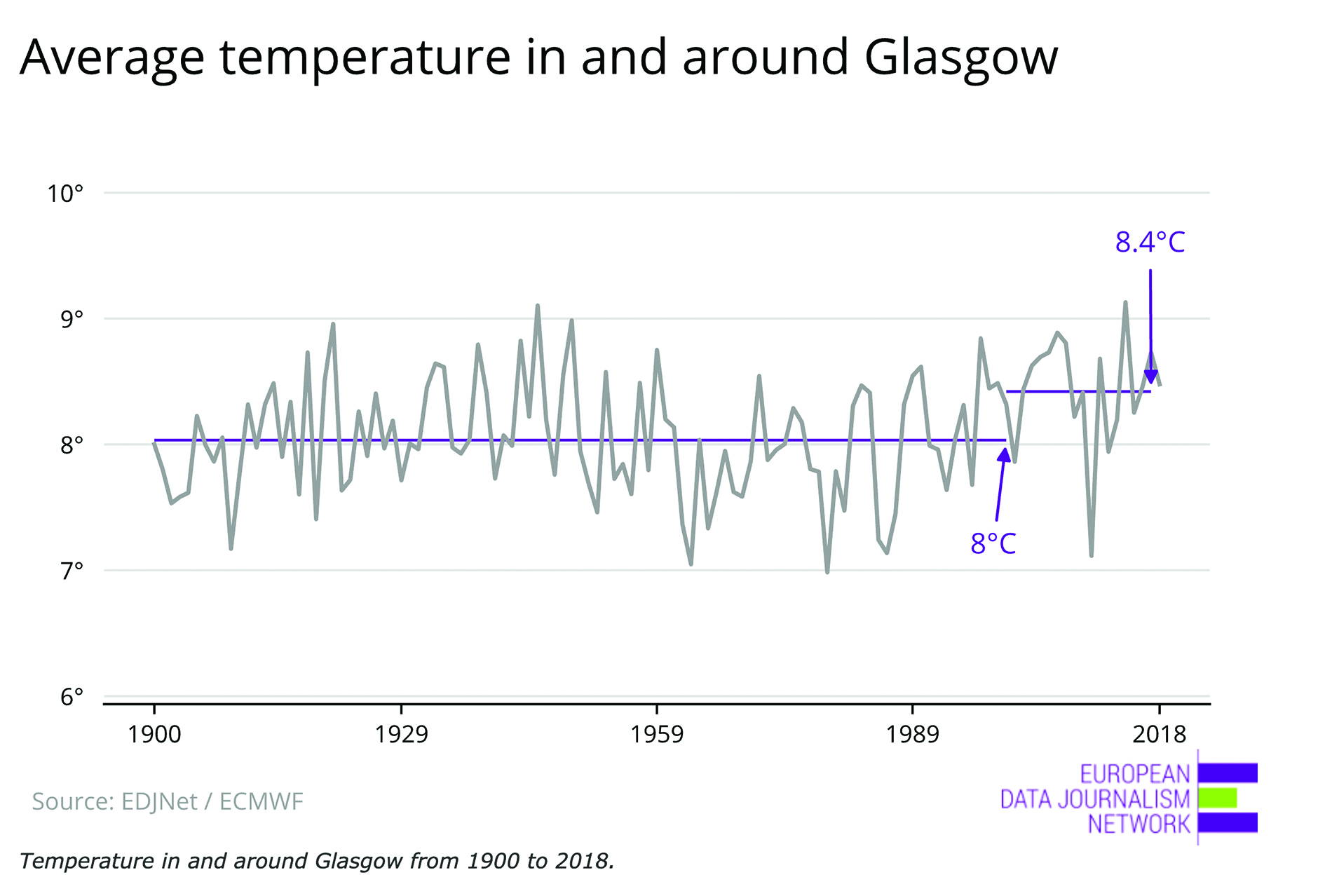

Figure: Temperature Data for Glasgow M8 Routing (Source: European Data Journalism Network).
5. Temporary Works must be Considered in Lifecycle Planning Large-scale propping operations can cost tens of millions and extend programme durations by years
6. Multi-Disciplinary Coordination is Critical
Urban viaduct repairs require enormous planning and collaboration between civil engineers, corrosion specialists, transport planners, utility companies and local authorities.
Summary
The Glasgow M8 Woodside Viaducts refurbishment is one
of Scotland’s most complex and significant corrosion-related infrastructure projects in recent decades. Built in the late 1960s and heavily modified in the 1990s, the viaducts have suffered extensive deterioration driven by chloride ingress, water penetration and long-term environmental exposure.
The discovery of severe crosshead deterioration in 2021 triggered lane restrictions and a multi-year emergency propping programme involving 23x bespoke structures.
Complicated interfaces with utilities, subway tunnels and densely built-up streets, combined with escalating material costs and discovery of an uncharted sewer, have pushed costs to above £150 million and moved completion to 2027. Alongside this, there was a significant campaign mounted to remove the previous scar through the city left by the building of the urban motorway and to restore lost residential areas and parkland.
Despite all of these challenges, the project is now advancing steadily. Once completed, the viaducts will have renewed structural capacity, enhanced durability and improved inspection access — securing the long-term future of a critical component of Scotland’s motorway network.
As with the past refurbishment of Edinburgh’s North Bridge featured in Corrosion Management July/August 2025 corrosion_ management_issue186lo-res.pdf this project serves as a timely reminder of the importance of planned maintenance, accurate records, modern corrosion and structural monitoring systems, and proactive asset management for the UK’s ageing civil infrastructure.
